Planning project · Planning application
Replacement of retaining wall at single-family home proposed on hillside lot
The application would replace a retaining wall at an existing single-family home on a 0.3-acre lot. City planners say it needs hillside review because of steep slopes and unstable soils, and a geotechnical report may be required. No parking changes are planned.

About this application
No description has been published for this record yet.
Project name on file: 1504 E SHENANDOAH DR
Timeline
Two days ago
7 documents added
Sept. 1, 2026
Concept Review Complete: CR Complete - Type 2
Aug. 14, 2026
Concept Review Complete: Engineering Preview
Aug. 14, 2026
Concept Review Complete: Engineering Preview Complete
Based on submitted documents and limited overview of the property, a determination has been made that this project will be a Category II Hillside project due to slope, erosion-prone soils, unstable soils, earth movement, and other geologic and hydrologic hazards. In addition to the already submitted documents (please submit them with subsequent applications), additional documents may be required during the CFH Review process.Additional documents that you can expect to provide will be a site-specific geotechnical report with the possibility of a global slope stability analysis (please see the Agency Comment for Hillside Retaining Wall Permitting within this PLN); structural calculations for any retaining wall system that is greater than four feet in height from top of foundation to top of wall, that has more than one wall when the interior horizontal distance between the walls is less than 10 feet and the total height of all walls exceeds four feet, that has a surcharge, that has a backslope greater than three feet horizontal to one foot vertical, or that has structural components (these requirements will be assessed again at the time of occupancy); and civil plans. Please refer to the Hillside Development Requirements for Technical Reports for grading & drainage plan and geotechnical report requirements.A subgrade inspection by a geotechnical firm will be required at the time of construction once the subgrade is exposed and prior to placement of foundation materials or forms/rebar. A report of the inspection will need to be submitted to and accepted by PW Hillside (HillsideDrainage@cityofboise.org) before scheduling your inspection with the Building Department and receiving final occupancy.NOTE: The hazards of developing and building on a property, especially in the Boise foothills, are well known. It is the responsibility of the applicant/owner’s design, geological, and engineering professionals, not the City, to identify, address, and mitigate any hazards to the site. Satisfying these Conditions of Approval is for limited [City purpose] only and should not be relied on for design, geological or engineering purposes. Developer will comply with all requirements of Boise City Hillside Development Code Sections or submit evidence satisfactory to the Boise City Engineer that the proposed development is exempt from the requirements therein stated due to location, topography and/or the absence of adverse conditions associated with slope stability, ground water, erosion and sedimentation.If you would like to discuss this determination, please contact us at HillsideDrainage@cityofboise.org. Please include your application number and address in the subject line.
Aug. 12, 2026
Application Submittal: Online
Aug. 12, 2026
Application filed
Documents

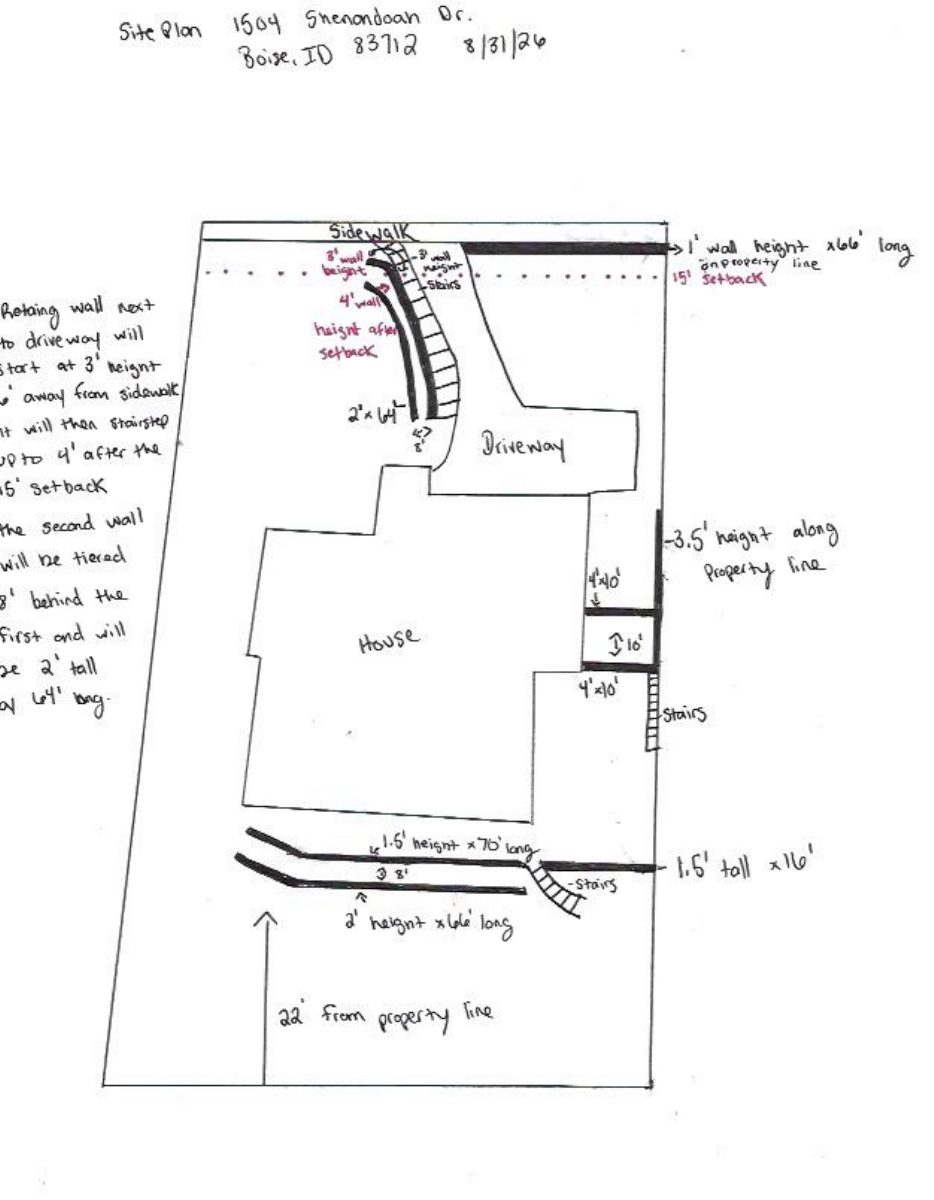

Site plans
- Download PDS-Maps and Drawings - SITE PLAN - UPDATED
Sept. 1, 2026 · 1 page · 93 KB · PDS-Maps and Drawings

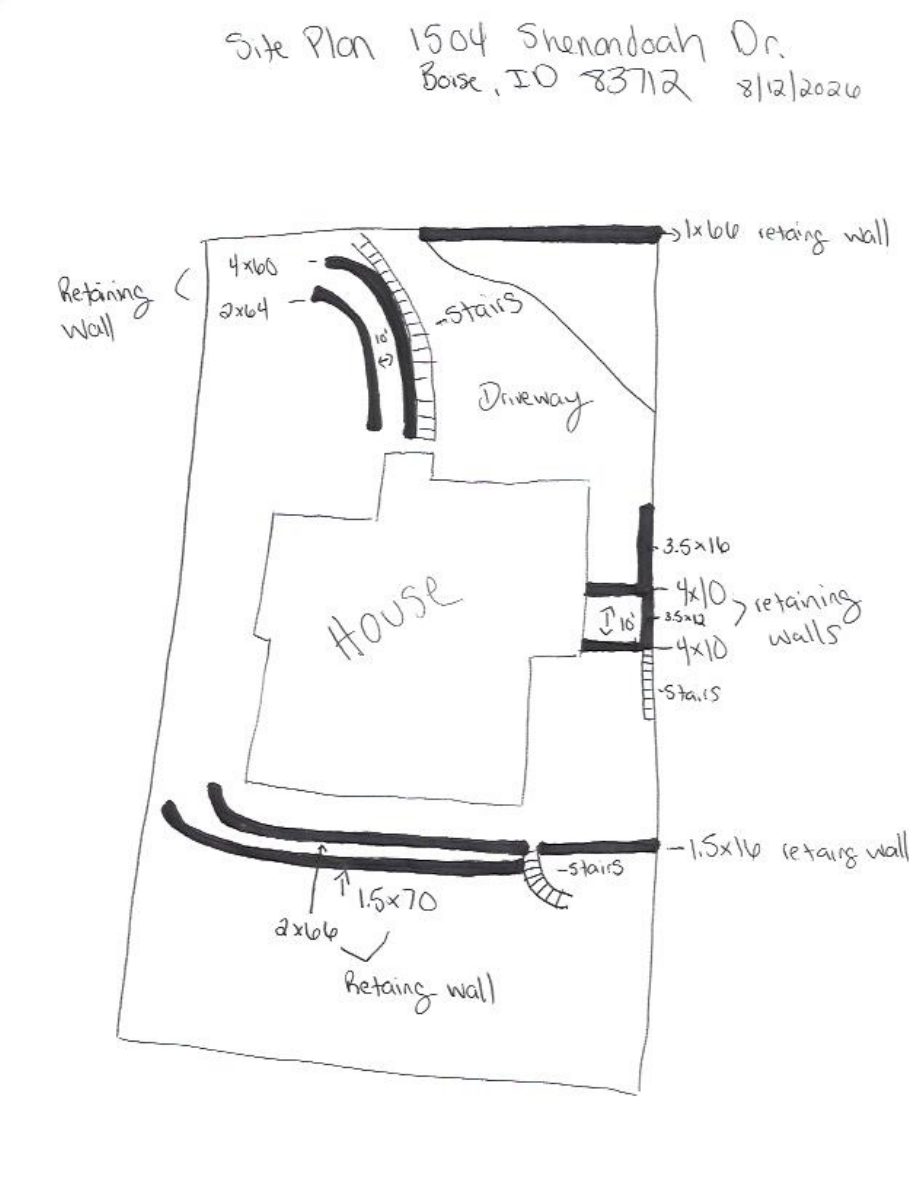

- Download PDS-Other Small Docs - SITE PLAN
Aug. 12, 2026 · 1 page · 77 KB · PDS-Other Small Docs
Project narrative
- Download PDS-Concept Review Summary Report -
Sept. 1, 2026 · 2 pages · 457 KB · PDS-Concept Review Summary Report
- Download PDS-Other Small Docs - PROJECT DESCRIPTION
Aug. 12, 2026 · 1 page · 115 KB · PDS-Other Small Docs
Application
- Download PDS-Application
Aug. 12, 2026 · 2 pages · 154 KB · PDS-Application
Other documents
- PDS-Agency Comments - HILLSIDE RETAINING WALL PERMITTING_OCTOBER2025
Aug. 14, 2026 · 804 KB · PDS-Agency Comments
- PDS-Other Small Docs - HILLSIDE QUESTIONNAIRE
Aug. 12, 2026 · 146 KB · PDS-Other Small Docs
