Subdivision · Planning application

6-lot subdivision with four new townhomes proposed, keeping existing house

The plan would split a 0.69-acre lot into six home lots and a shared-driveway lot, adding one new home and four townhomes behind the existing house. The Planning and Zoning Commission recommended approval after its Aug. 10 meeting; City Council will set a hearing.

In reviewSUB26-00022Filed May 15, 2026Northwest · 9820 W Shields Ave+3 related filings

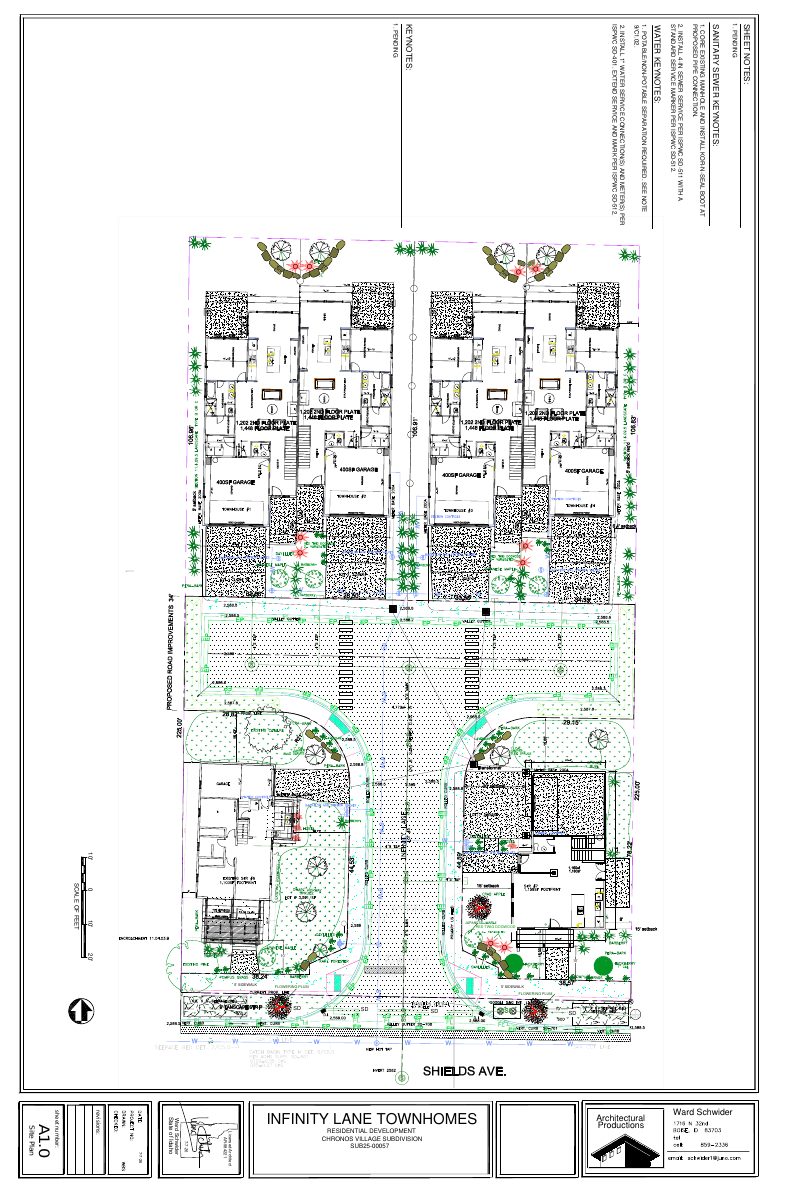

Site plan for 6-lot subdivision with four new townhomes proposed, keeping existing house
Site plan from the application documents.
Pin at the reported location; the shaded outline is the primary parcel (Ada County).

From the filing

The application's description as it appears in City of Boise's record. See the official record

The applicant proposes dividing a 0.69-acre lot at 9820 W Shields Ave into seven lots: six for homes and one common lot for a shared driveway. The existing house would stay, with one new single-family home and four attached townhomes added behind it. Staff recommends approval, and the Planning and Zoning Commission will make a recommendation to City Council.

Residential subdivision

Project name on file: 9820 W SHIELDS AVE

Timeline

  1. Aug. 12, 2026

    Recommend Approval

    Hearing marked “Recommend Approval” on 2026-08-12.

  2. Aug. 12, 2026

    Hearing: Recommend Approval

  3. Aug. 12, 2026

    Review Complete: Completed

  4. Aug. 12, 2026

    Planning and Zoning: Complete

  5. Aug. 10, 2026

    Public hearing: Planning and Zoning Commission

  6. July 20, 2026

    Planning and Zoning: In Review

  7. July 20, 2026

    Assign Reviewers: Completed

  8. July 15, 2026

    Review Complete: Corrections Required

  9. July 15, 2026

    Planning and Zoning: Corrections Required

  10. July 14, 2026

    Planning and Zoning: In Review

  11. July 14, 2026

    Assign Reviewers: Completed

  12. July 10, 2026

    Review Complete: Corrections Required

  13. July 10, 2026

    Planning and Zoning: Corrections Required

  14. July 9, 2026

    Planning and Zoning: In Review

  15. July 9, 2026

    Assign Reviewers: Completed

  16. June 25, 2026

    Review Complete: Corrections Required

  17. June 25, 2026

    Planning and Zoning: Corrections Required

  18. June 17, 2026

    Planning and Zoning: In Review

  19. June 17, 2026

    Assign Reviewers: Completed

  20. June 16, 2026

    Fee Payment: Payment Received

  21. May 19, 2026

    Prescreen Review: Passed

  22. May 19, 2026

    Prescreen Review: In Progress

  23. May 15, 2026

    Application Submittal: ePlanReview

  24. May 15, 2026

    Application filed

Documents

Site plans

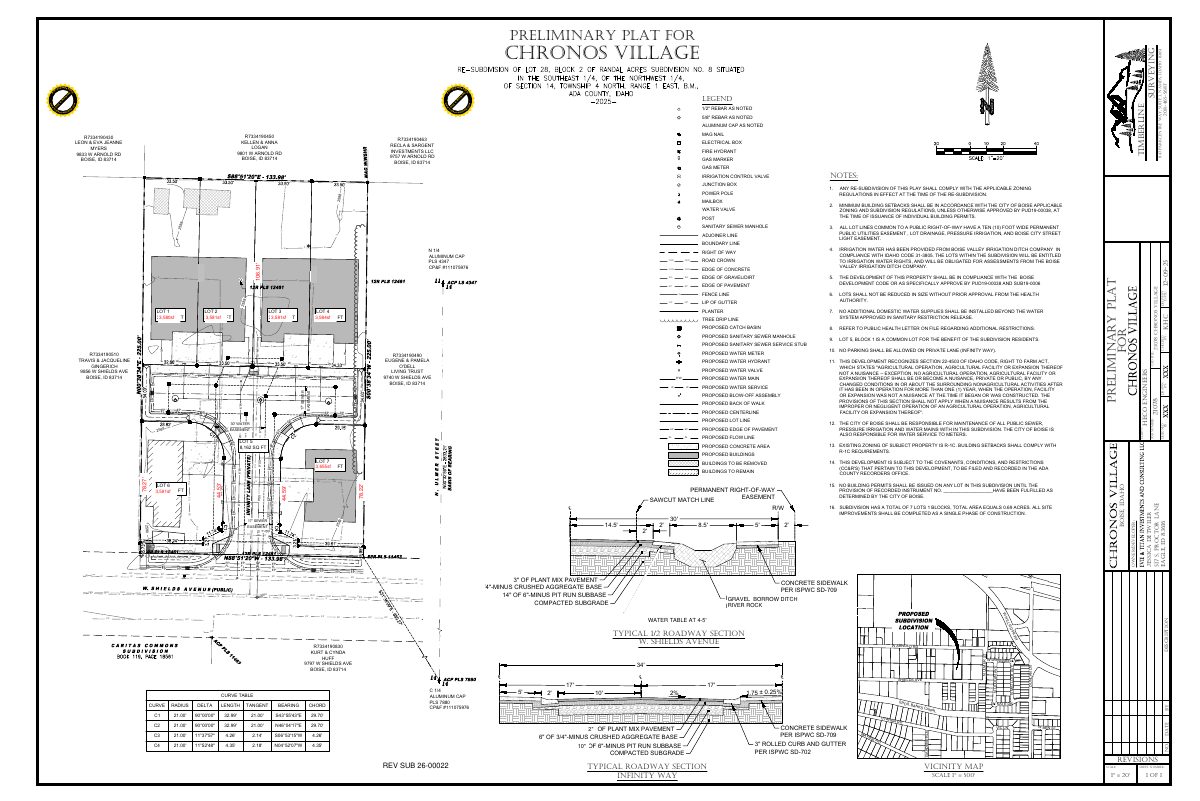

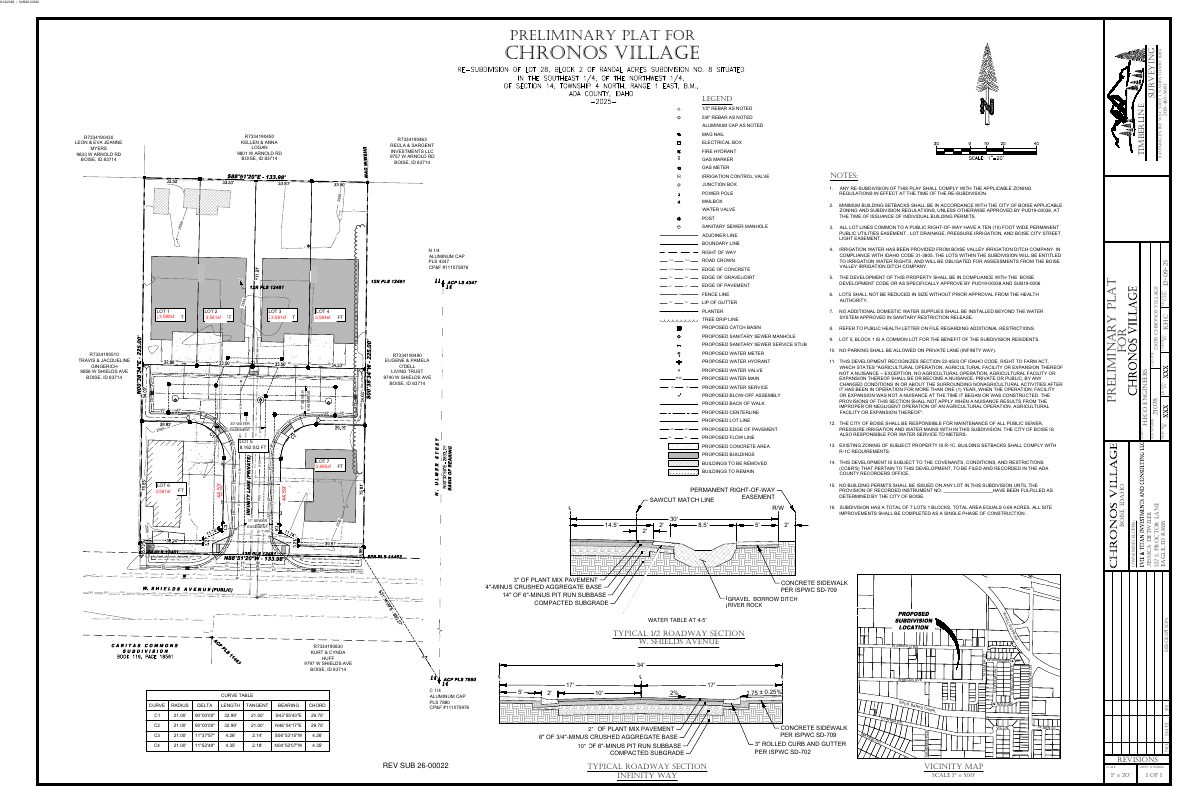

  • Revised preliminary plat for the Chronos Village subdivision, with notes on building setbacks, a ten-foot utility and drainage easement, irrigation water rights, and lot size limits.

    July 27, 2026 · 1 page · 720 KB · PDS-Maps and Drawings

    Download Revised preliminary plat
  • Surveyed preliminary plat showing lot layout, easements, and notes on zoning, setbacks, irrigation water rights, and compliance with the PUD and subdivision approvals.

    July 9, 2026 · 1 page · 719 KB · PDS-Maps and Drawings

    Download Revised preliminary plat for Chronos Village
  • Preliminary plat drawing by a surveying firm, with legend and notes on setbacks, easements, irrigation water rights and compliance with the Boise development code.

    June 24, 2026 · 1 page · 715 KB · PDS-Maps and Drawings

    Download Preliminary plat for Chronos Village

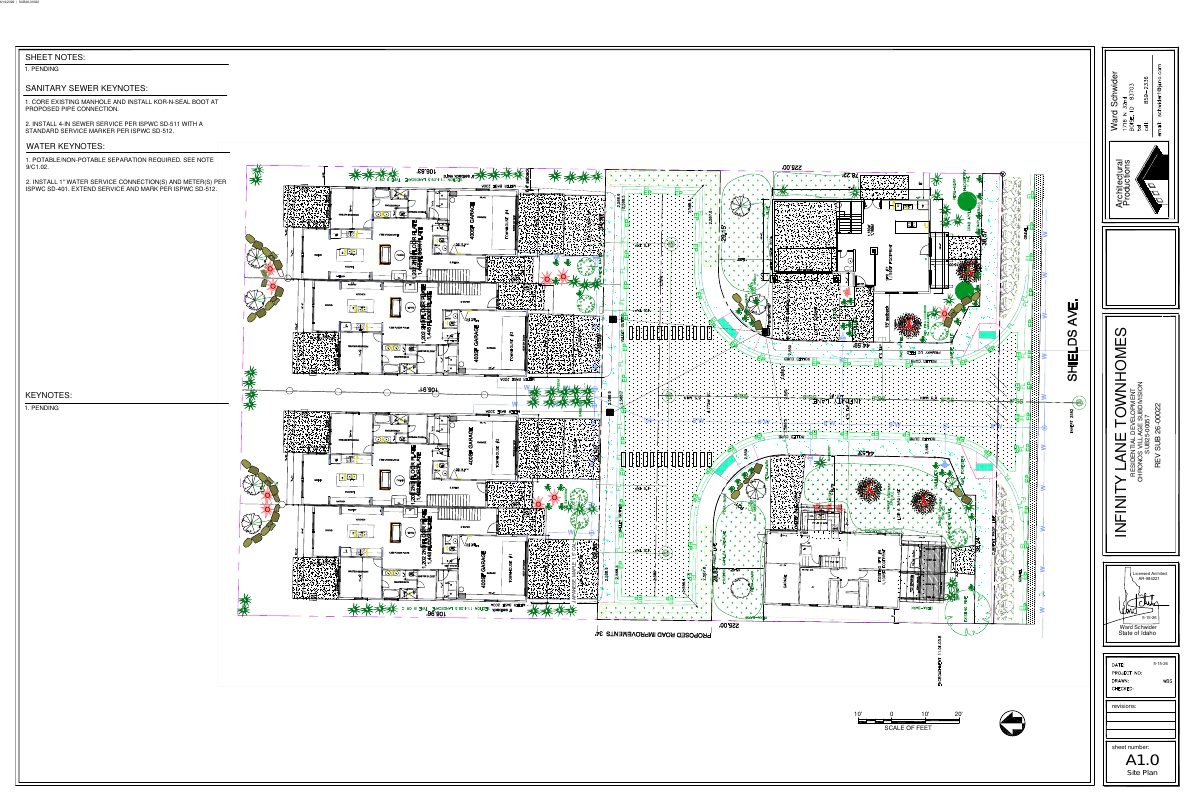

  • Site plan sheet A1.0 for the Infinity Lane Townhomes residential development, with sanitary sewer and water service keynotes.

    June 24, 2026 · 1 page · 970 KB · PDS-Maps and Drawings

    Download Proposed site plan

Plans

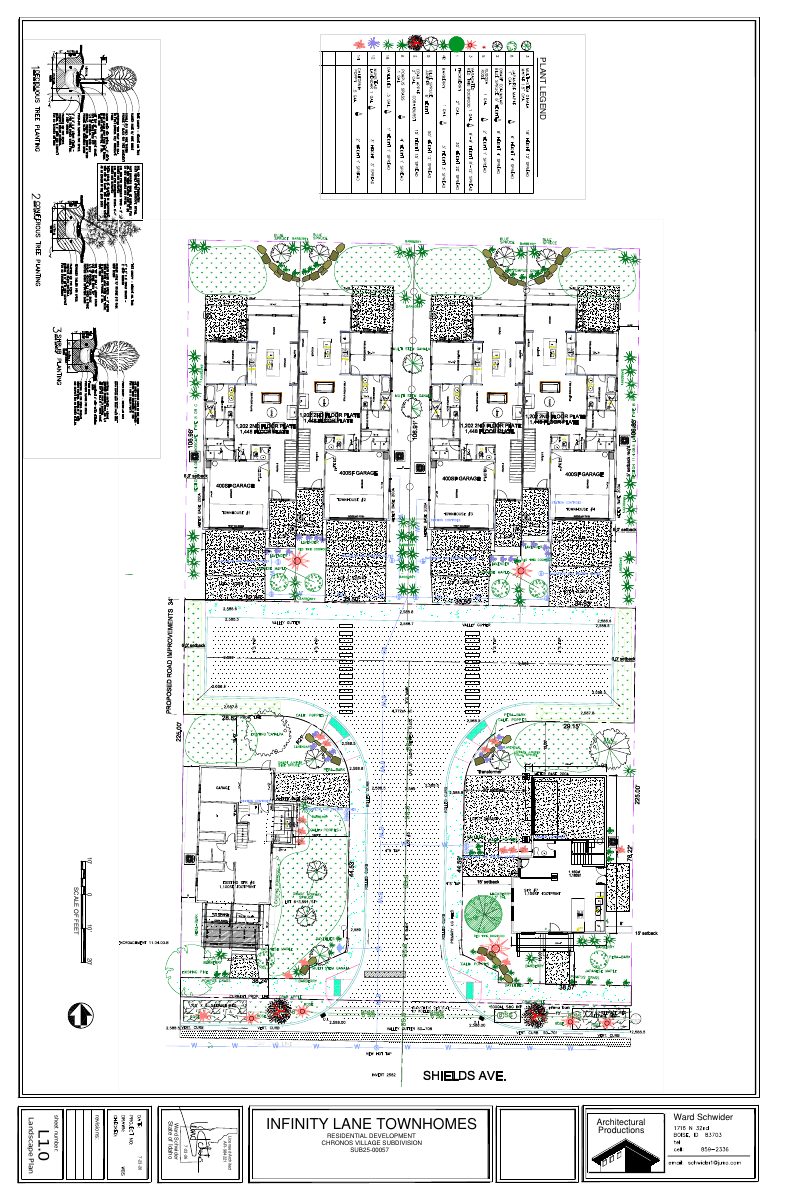

  • Revised landscape plan sheet L1.0 for the Infinity Lane Townhomes residential subdivision, with a plant legend and scale bar.

    July 31, 2026 · 1 page · 1.2 MB · PDS-Maps and Drawings

    Download Revised landscape plan
  • Revised final plat for a re-subdivision of Lot 28, Block 2 of Randal Acres Subdivision No. 8, with lot layout, easements, and notes on zoning, irrigation, and health restrictions.

    July 27, 2026 · 2 pages · 725 KB · PDS-Maps and Drawings

    Download Revised final plat
  • Revised landscape plan sheet for the subdivision, showing plantings such as flowering plum and red twig dogwood along a 5-foot sidewalk.

    July 9, 2026 · 1 page · 1.0 MB · PDS-Maps and Drawings

    Download Revised proposed landscape plan
  • Assessor's reference map with a legend of roads, parks, townships, sections and zoning classes, generated from an internet mapping site and not for navigation or legal use.

    June 24, 2026 · 1 page · 545 KB · PDS-Maps and Drawings

    Download Ada County Assessor zoning map

  • Final subdivision plat for a re-subdivision of a lot in Randal Acres, with lot layout, easements, and notes on zoning, irrigation, water supply, and common lot use.

    June 24, 2026 · 2 pages · 731 KB · PDS-Maps and Drawings

    Download Final plat

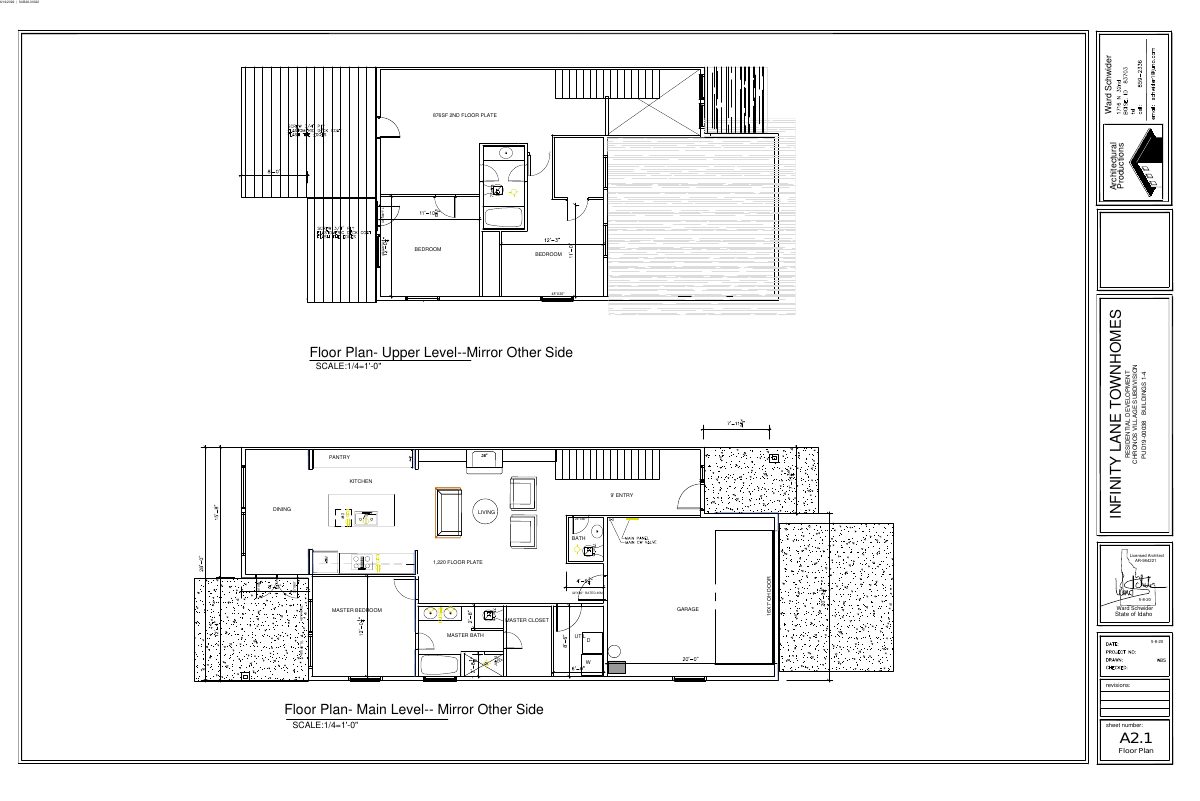

  • Architectural floor plan sheet for the upper level of the Infinity Lane townhomes, showing bedrooms, closets, and baths at 1/4-inch scale.

    June 24, 2026 · 1 page · 118 KB · PDS-Maps and Drawings

    Download Proposed upper-level floor plan, mirrored townhome

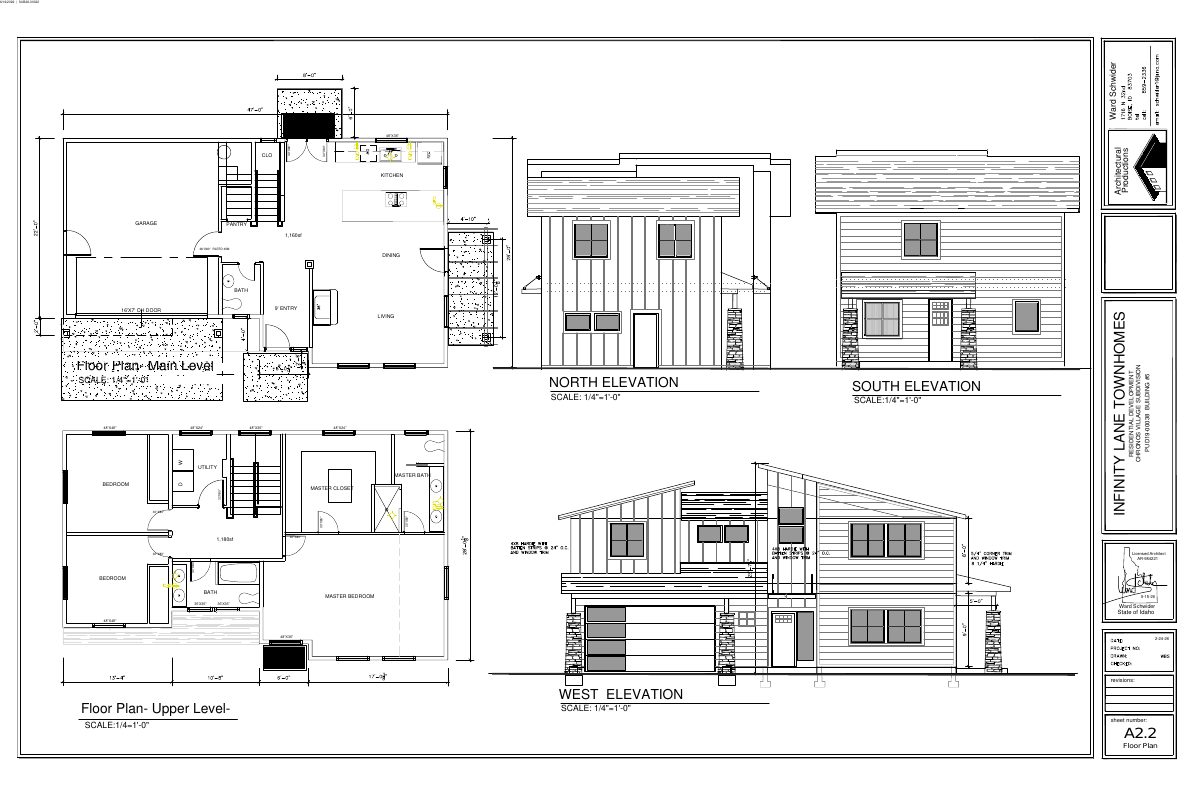

  • Architectural sheet showing main and upper level floor plans and north, south and west elevations for a townhome in the Infinity Lane Townhomes section of Chronos Village Subdivision, sheet A2.2.

    June 24, 2026 · 1 page · 152 KB · PDS-Maps and Drawings

    Download Proposed floor plans and elevations, Building 5

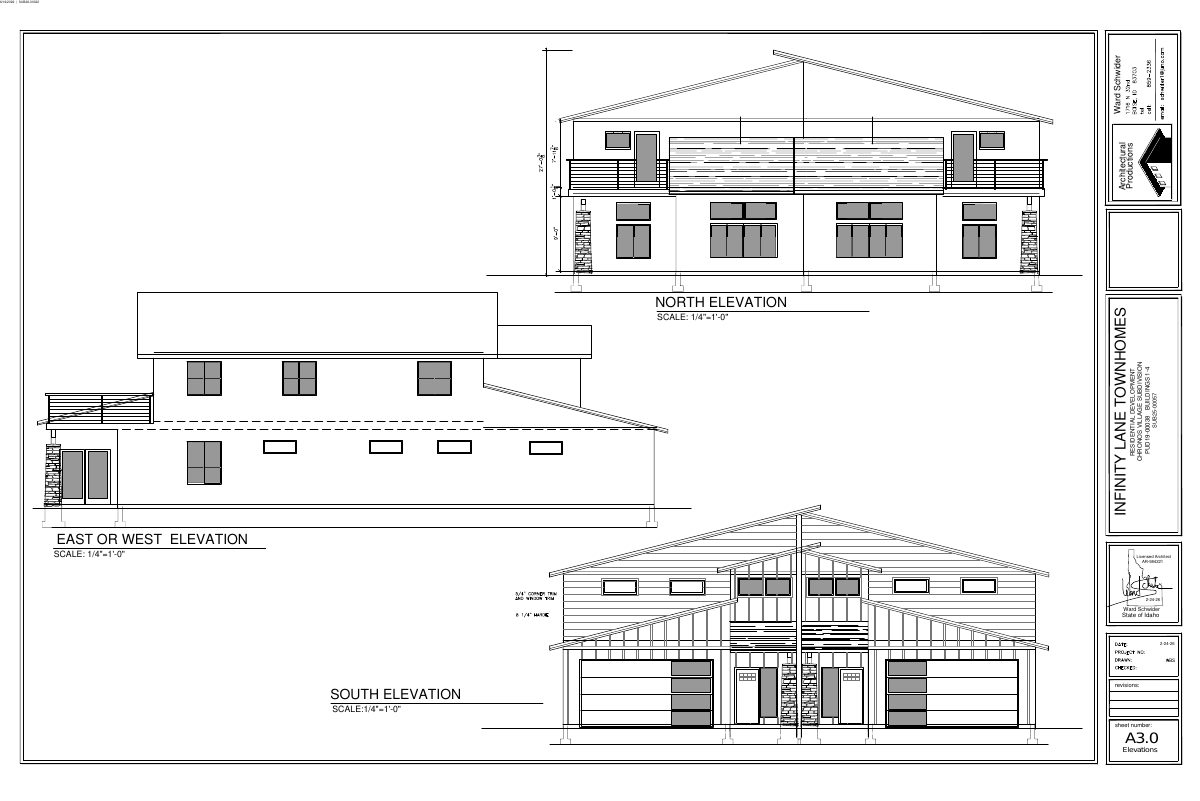

  • Architectural elevation drawings for the Infinity Lane townhomes in the Chronos Village subdivision, sheet A3.0, dated 2-24-26 with a 6-16-2026 upload.

    June 24, 2026 · 1 page · 92 KB · PDS-Maps and Drawings

    Download Proposed townhome elevations, north, east/west and south

Project narrative

  • Project description for a subdivision proposal: four townhome lots, one duplex lot, and a lot for the existing single-family home, served by a common driveway.

    June 24, 2026 · 1 page · 128 KB · PDS-Letter of Intent

    Download Letter of intent, subdivision project description

Staff reports

Decisions

  • Letter notifying the applicant that the Aug. 10 Planning and Zoning Commission recommended approval of a six-lot subdivision plat, subject to listed conditions of approval.

    Aug. 12, 2026 · 11 pages · 268 KB · PDS-Action Letter

    Download Planning and Zoning Commission action letter

Application

  • Application for a 7-lot residential subdivision (6 buildable, 1 common) on a 0.69-acre R-1C parcel, with a 34-foot private street and on-site bio retention stormwater.

    June 24, 2026 · 3 pages · 209 KB · PDS-Application

    Download Subdivision application form, preliminary/final plat
  • Application form for a five-lot single-family subdivision plus one existing home renovation, filed by Boise Hunter Homes with a Hillside Questionnaire link noted.

    June 24, 2026 · 2 pages · 176 KB · PDS-Application

    Download Subdivision application form for Infinity Lane Townhomes
  • City of Boise form for applicants seeking Assured Water Supply certification for development served by a Designated Water Provider, filed with a subdivision application.

    June 24, 2026 · 10 pages · 195 KB · PDS-Other Small Docs

    Download Assured Water Supply application B for a DWP service area
  • Application for a 7-lot residential subdivision (6 buildable, 1 common) in R-1C zoning, with a 34-foot private street and on-site bioretention stormwater.

    May 15, 2026 · 3 pages · 206 KB · PDS-Application

    Download Subdivision application form, preliminary/final

Correspondence

  • Staff-level approval letter for the preliminary plat, citing prior ACHD approval conditions and listing standard right-of-way conditions of approval.

    July 31, 2026 · 10 pages · 1.2 MB · PDS-Agency Comments

    Download Ada County Highway District comments on preliminary plat
  • Central District Health's Division of Community and Environmental Health transmittal with its review checkboxes, including requirements for sewage, water and infiltration beds.

    July 31, 2026 · 1 page · 947 KB · PDS-Agency Comments

    Download Central District Health comments on subdivision application
  • Parks and Community Forestry request an arborist assessment of existing trees and mitigation calculations for tree removal and replacement planting.

    July 31, 2026 · 1 page · 63 KB · PDS-Agency Comments

    Download Boise Parks and Recreation comments on revised landscape plan
  • The irrigation company requires a recorded license agreement and its written approval before any work within its canal or Lateral 36 easement, including planned West and South side improvements.

    July 28, 2026 · 1 page · 55 KB · PDS-Agency Comments

    Download Boise Valley Irrigation Ditch Co. comments
  • Fire Department review of the subdivision plat requiring hydrant spacing, fire apparatus access road width, turning radius, and load-capacity compliance under the International Fire Code.

    July 28, 2026 · 2 pages · 210 KB · PDS-Agency Comments

    Download Boise Fire Department comments
  • Parks staff note two existing trees over 4 inches in diameter, request an arborist assessment, and ask for a landscape plan for new plantings.

    July 28, 2026 · 1 page · 111 KB · PDS-Agency Comments

    Download Boise Parks and Recreation comments on subdivision tree and landscape plan
  • Public Works conditions on subdivision grading, stormwater runoff retention, stormwater management plan timing, and private street testing requirements.

    July 28, 2026 · 1 page · 139 KB · PDS-Agency Comments

    Download Public Works hillside and drainage comments
  • Boise Public Works standard pressure irrigation and sewer conditions for the subdivision, including plan submittal, inspection, bonding and fee requirements.

    July 28, 2026 · 3 pages · 171 KB · PDS-Agency Comments

    Download Public Works sewer and irrigation conditions
  • Public Works form itemizing sewer assessment and connection fees due for the subdivision, including a credit for the existing home on Lot 6, totaling $11,546.90.

    July 28, 2026 · 1 page · 81 KB · PDS-Agency Comments

    Download Sewer rating fees form for Chronos Village subdivision
  • Boise Public Works Solid Waste staff report no comments and find solid waste OK as planned, and link trash enclosure design and location standards.

    July 28, 2026 · 1 page · 88 KB · PDS-Agency Comments

    Download Public Works solid waste comments
  • Public Works street light trades supervisor reports no comments on the subdivision application.

    July 28, 2026 · 1 page · 125 KB · PDS-Agency Comments

    Download Public Works street light comments
  • Letter notifying the applicant that the subdivision application will be heard on Aug. 10, 2026, in person or via Zoom, with agency comments and a project report posted beforehand.

    July 22, 2026 · 1 page · 121 KB · PDS-Correspondence

    Download Notice of the Aug. 10 Planning and Zoning Commission hearing

Other documents

  • Aerial map

    July 14, 2026 · 1.5 MB · PDS-Maps and Drawings

  • Land use map

    July 14, 2026 · 573 KB · PDS-Maps and Drawings

  • Zoning map

    July 14, 2026 · 601 KB · PDS-Maps and Drawings

  • 8.5 x 11 zoning map

    July 9, 2026 · 549 KB · PDS-Maps and Drawings

  • Agency transmittal

    July 9, 2026 · 132 KB · PDS-Transmittal Agencies

  • Statement of legal interest

    June 24, 2026 · 117 KB · PDS-Statement of Legal Interest

  • Submittal checklist

    June 24, 2026 · 913 KB · PDS-Submittal Checklist

Nearby

The Boise Builds daily briefing

Every new planning application in the Treasure Valley, and every filing that changed, in one email each morning. See a sample

Free. One email a day, only when something is new. Unsubscribe anytime.
